History
-
1884August 1884State engineer E.S. Nettleton conducts the first preliminary survey of a possible diversion project to import West Slope water to the Front Range.
-
18891889
-
18901890
-
1902June 17, 1902
-
July 1902Secretary of the Interior Ethan Allen Hitchcock establishes the U.S. Reclamation Service within the U.S. Geological Survey to study potential water development projects in 17 western states.
-
19051905
-
19071907The Reclamation Service becomes a separate organization within the Interior Department and is renamed the Bureau of Reclamation.
-
1915Jan. 26, 1915
-
19211921The U.S. Congress officially changes the name of the Grand River to the Colorado River. Proponents request the change to officially identify the headwaters of the Colorado River and differentiate it from the Green River in Wyoming.
-
1922Nov. 24, 1922
-
19301930
-
1933Aug. 17, 1933Northern Colorado leaders organize the Grand Lake Committee – predecessor to the Northern Colorado Water Users Association and the Northern Colorado Water Conservancy District (NCWCD/Northern Water) – to pursue a Grand Lake water diversion project.
-
December 1933Engineers report that a Grand Lake water diversion project is feasible.
-
1935January 1935The Reclamation Service allots $150,000 to survey and estimate costs for the Grand Lake Project.
-
Jan. 25, 1935Grand Lake Project proponents establish the Northern Colorado Water Users Association.
-
1936July 1, 1936Congress officially renames the Grand Lake Project the Colorado-Big Thompson Project.
-
1937May 13, 1937Colorado Governor Teller Ammons signs the Conservancy District Act into law.
-
June 1937
-
June 11, 1937The Northern Colorado Water Users Association and the Western Slope Protective Association reach an agreement to endorse the C-BT Project, including construction of Green Mountain Reservoir.
-
June 15, 1937
-
June 24, 1937Congress approves Senate Document 80, authorizing construction of the C-BT Project.
-
Aug. 9, 1937
-
Sept. 20, 1937The District Court of Weld County orders the creation of Northern Water.
-
Sept. 28, 1937
-
Nov. 12, 1937Interior Secretary Harold Ickes considers protests against C-BT Project funding, but he determines the project is feasible and forwards his findings to President Roosevelt.
-
Dec. 27, 1937President Roosevelt concurs with Harold Ickes and grants the C-BT Project final approval.
-
1938June 28, 1938Northeastern Colorado voters authorize Northern Water to sign a contract with the United States and to assess a 1 mill ad valorem tax on all properties within Northern Water boundaries to build and operate the C-BT Project. The measure is approved by a 17:1 margin.
-
July 5, 1938Northern Water signs a contract with the United States to repay a portion of C-BT Project construction costs.
-
Dec. 1, 1938
-

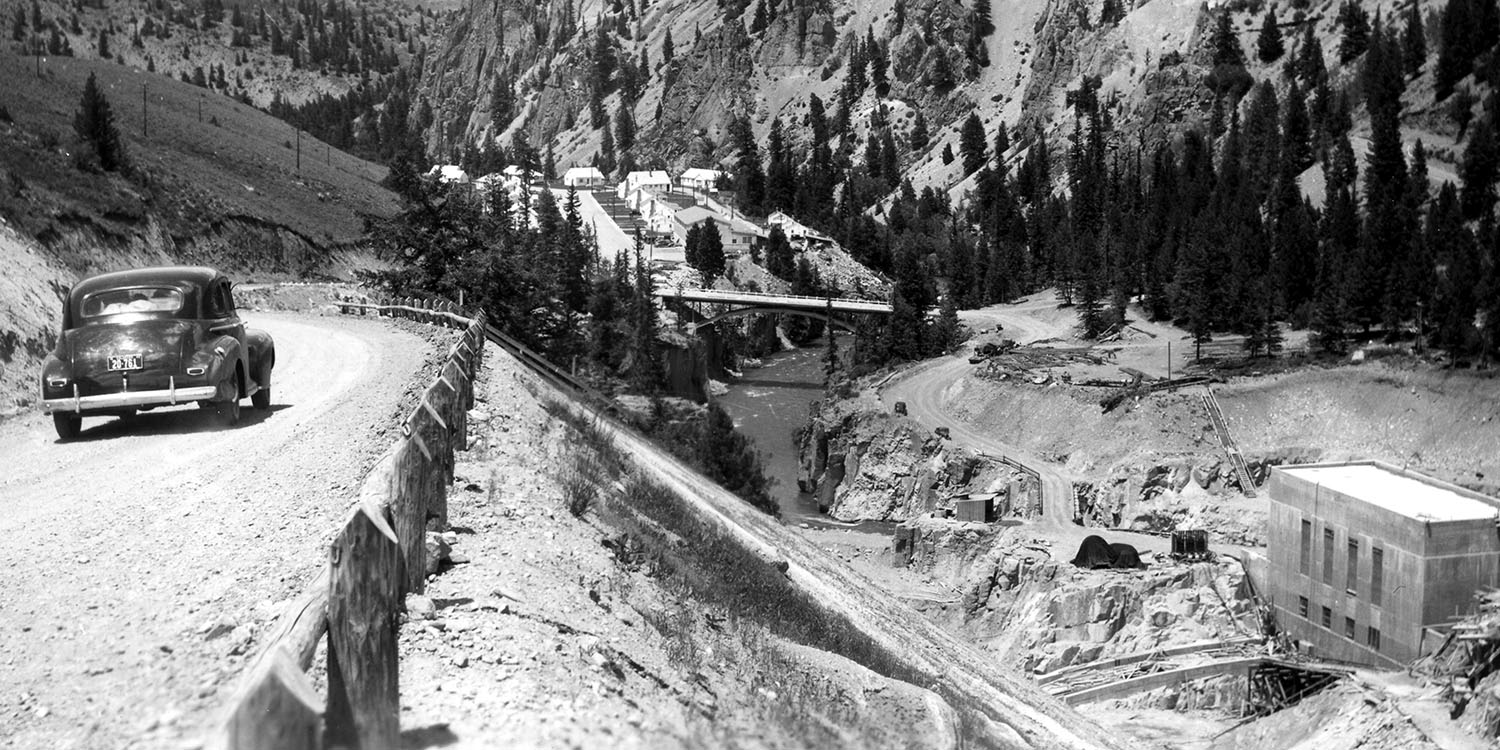

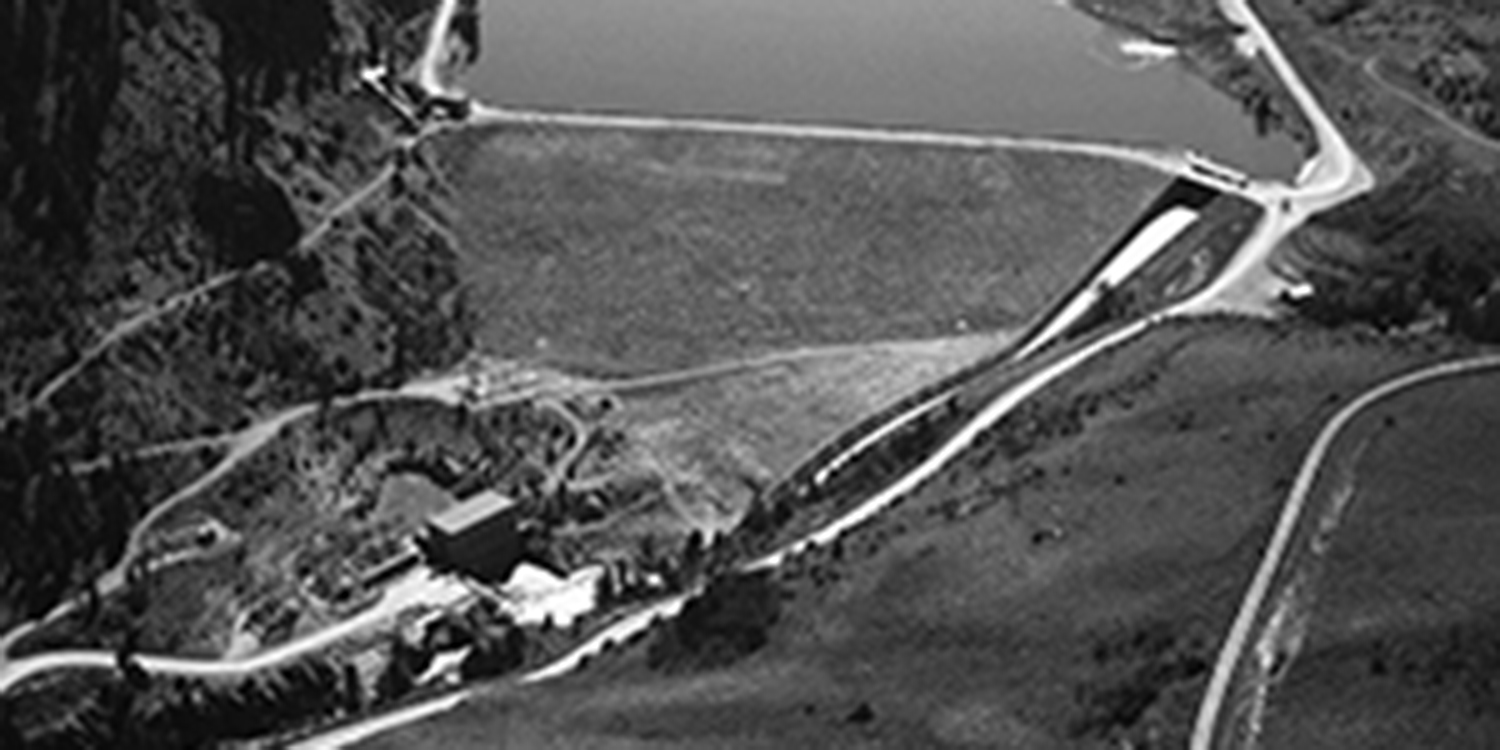

1940June 23, 1940Construction begins on the Continental Divide Tunnel. One crew begins from Grand Lake on the West Slope while a second team tunnels from a location near Estes Park on the East Slope. When complete the tunnel is the longest ever built from two separate headings.
-
1941Dec. 5, 1941
-
1942Dec. 31, 1942The War Production Board halts all construction work on C-BT Project features except the power plant at Green Mountain Reservoir.
-
1943May 1943
-
July 1943The War Production Board allows C-BT Project construction to resume on a limited basis.
-

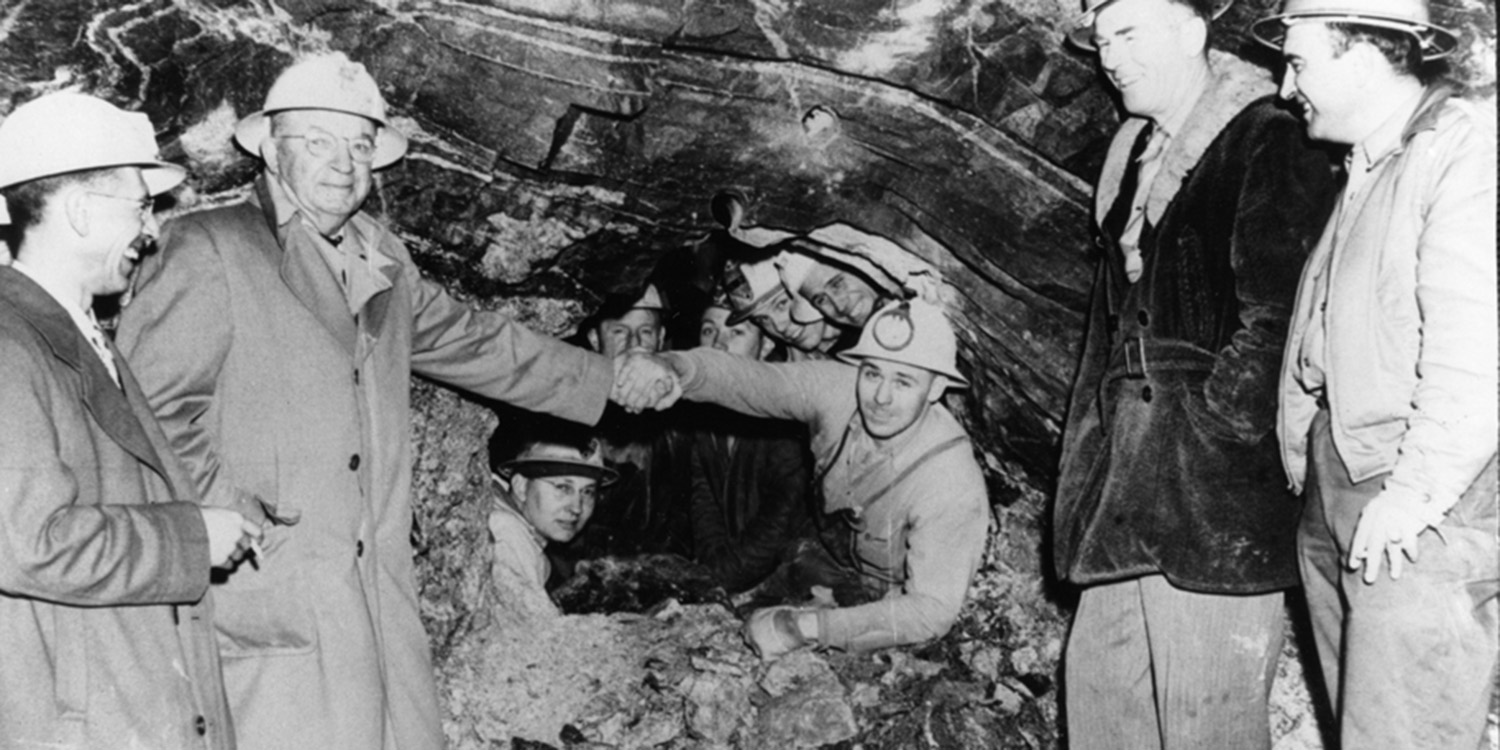

1944April 24, 1944
-
June 10, 1944
-
Dec. 21, 1944President Roosevelt signs legislation to rename the tunnel after the late Senator Alva B. Adams.
-
1945November 1945Construction workers complete Shadow Mountain Dam and spillway.
-
19471947The C-BT Project diverts 6,014 acre feet of water to the East Slope for irrigation.
-
June 23, 1947
-

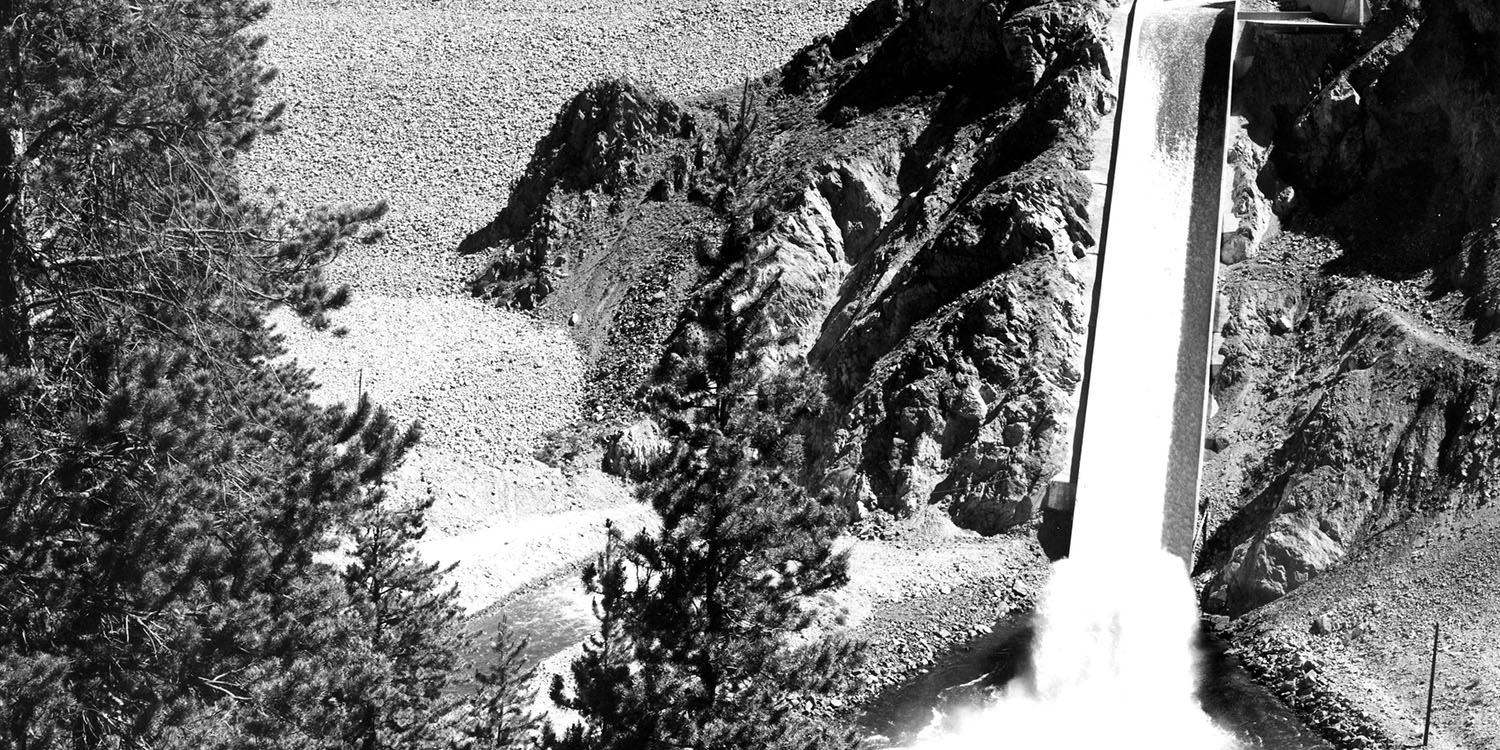

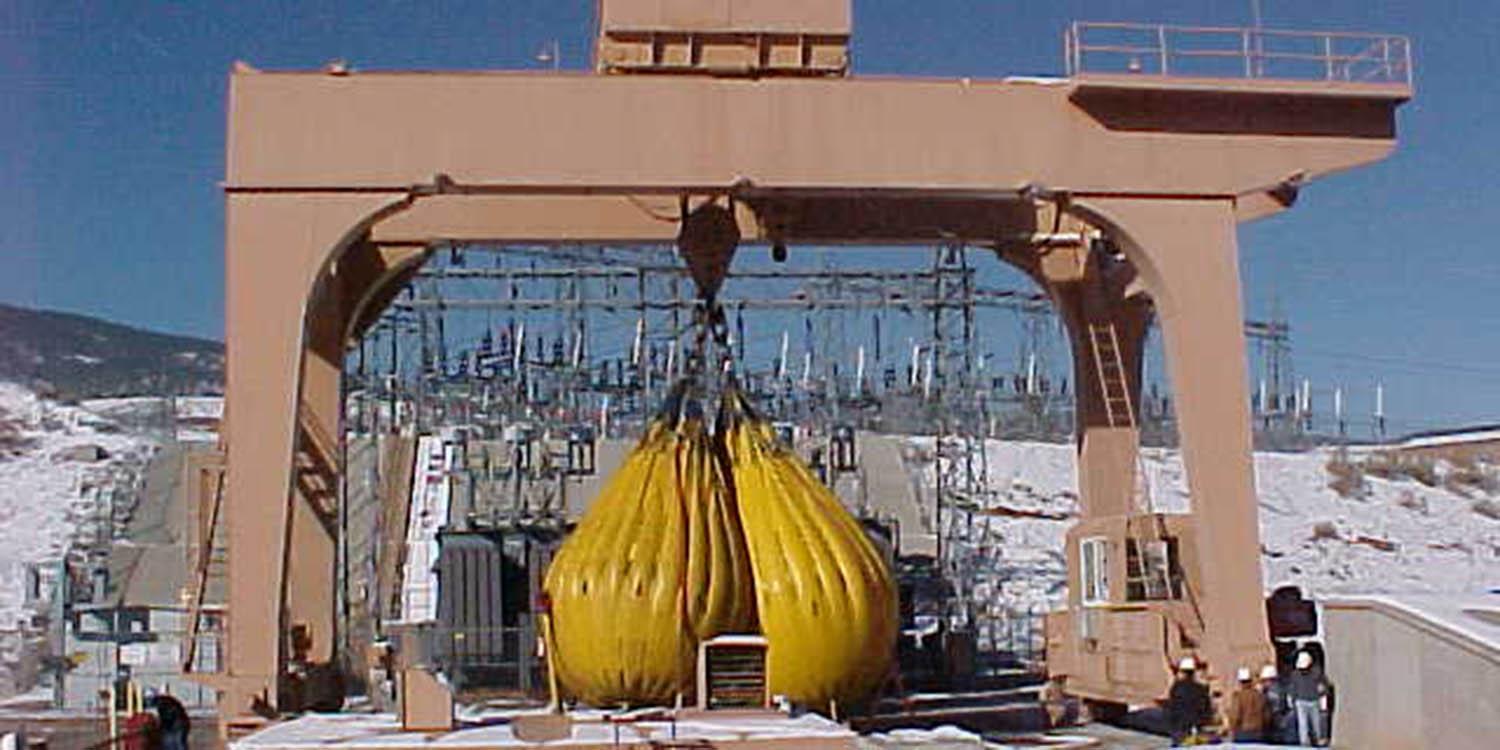

1948Nov. 1, 1948Crews close the gates at Olympus Dam, enabling water to be stored in Lake Estes.
-
1949Sept. 14, 1949
-
1950July 19, 1950
-
1951Jan. 10, 1951
-

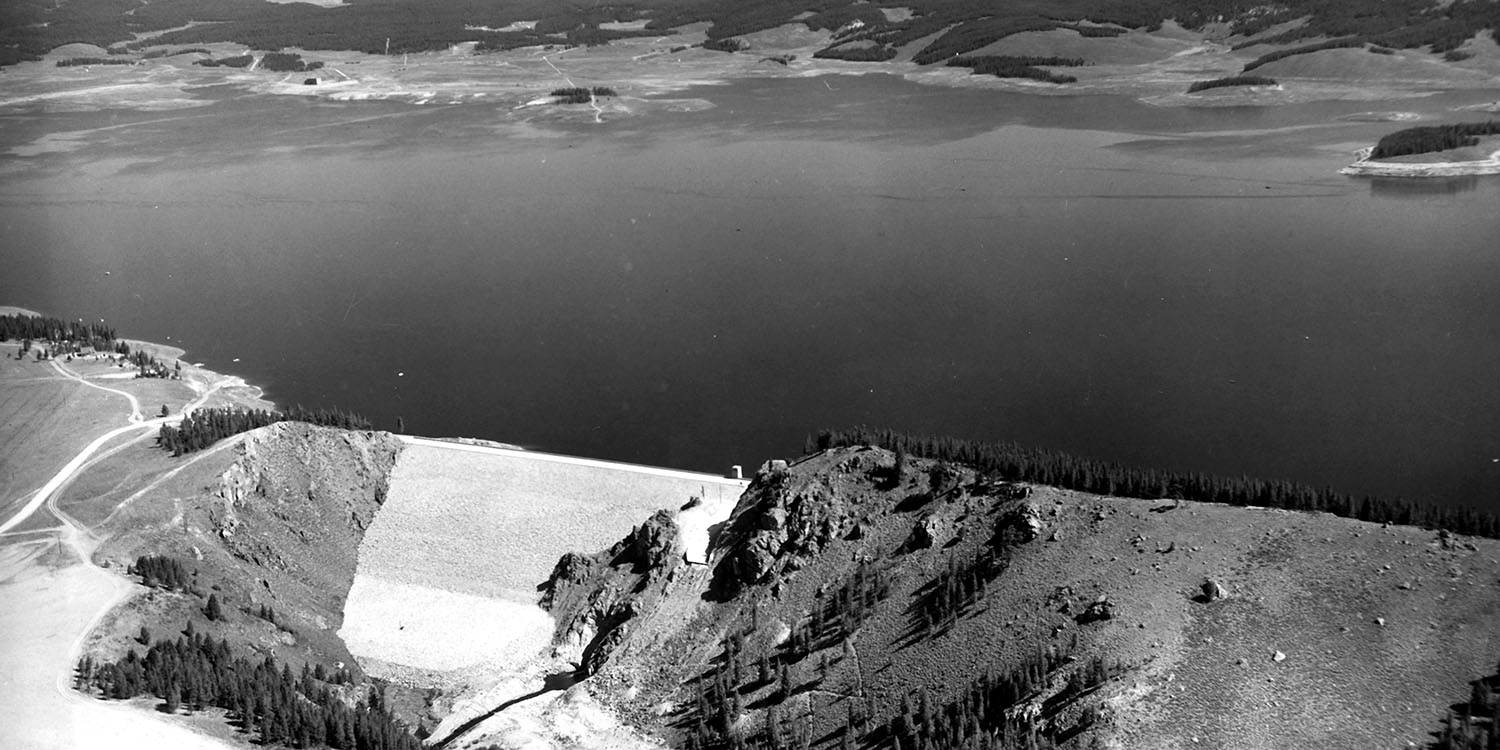

Jan. 25, 1951Water is pumped from Lake Granby into Shadow Mountain Reservoir for the first time.
-
July 20, 1951Colorado Gov. Lee Knous and others dedicate the Granby Pump Plant and sponsor a fishing contest in conjunction with the ceremony.
-

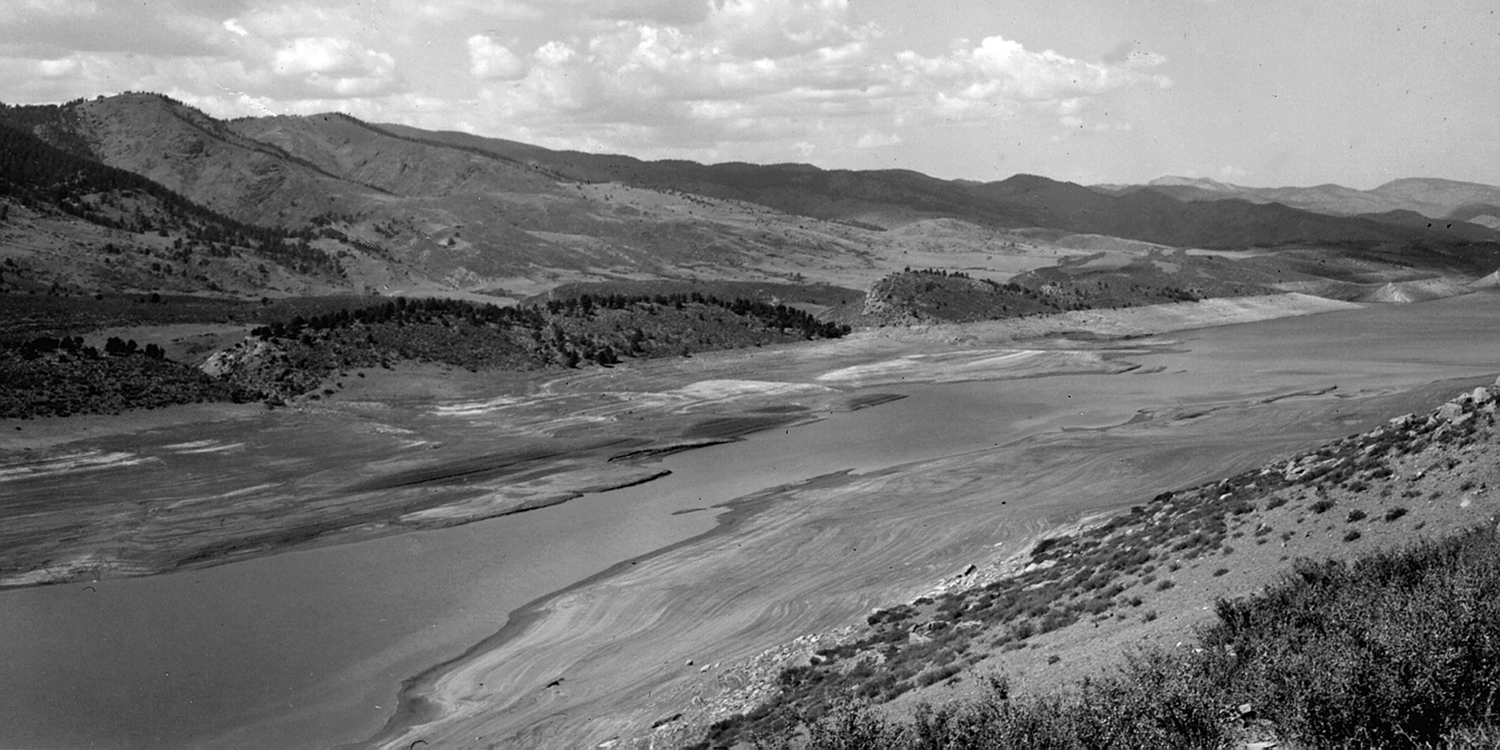

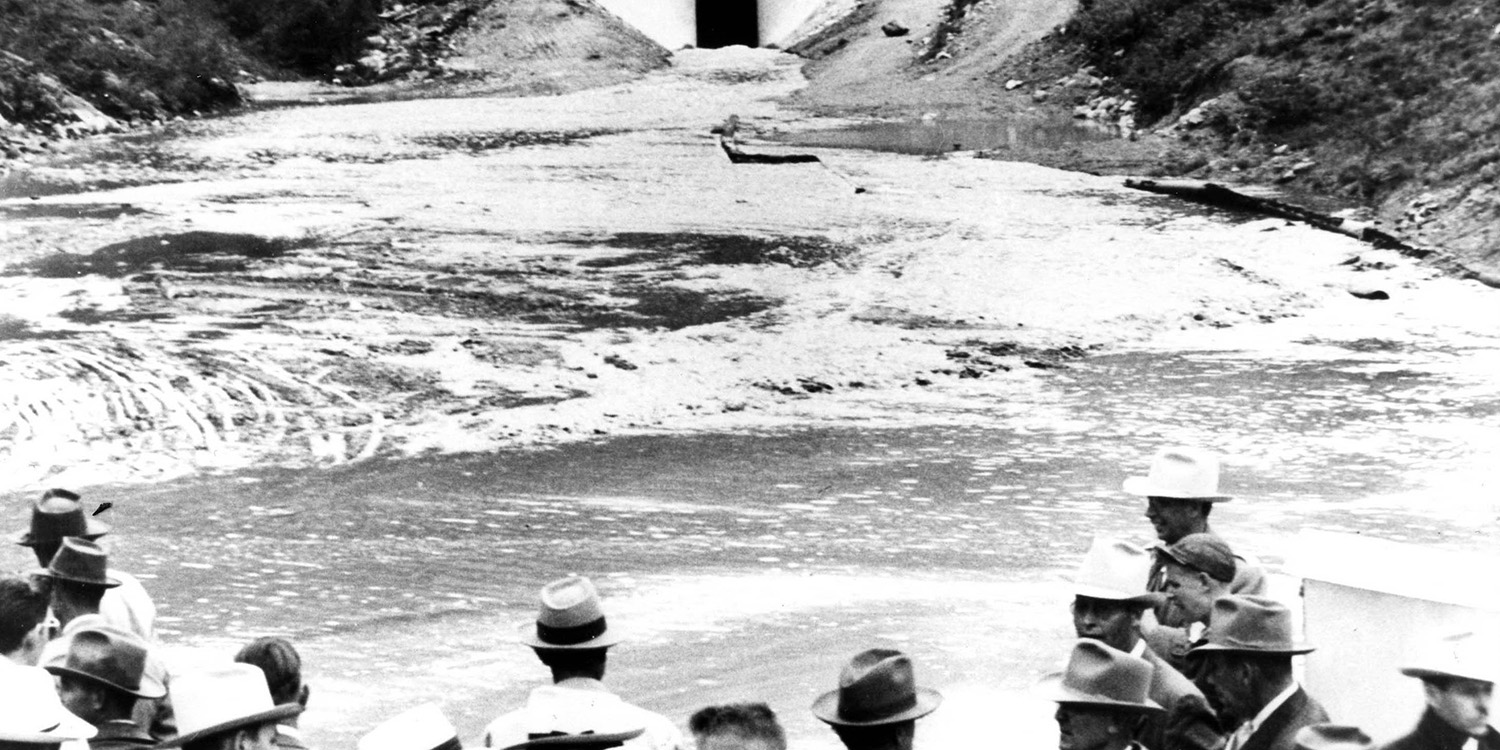

July 21, 1951The first C-BT Project water is released from Horsetooth Reservoir into the Poudre River.
-

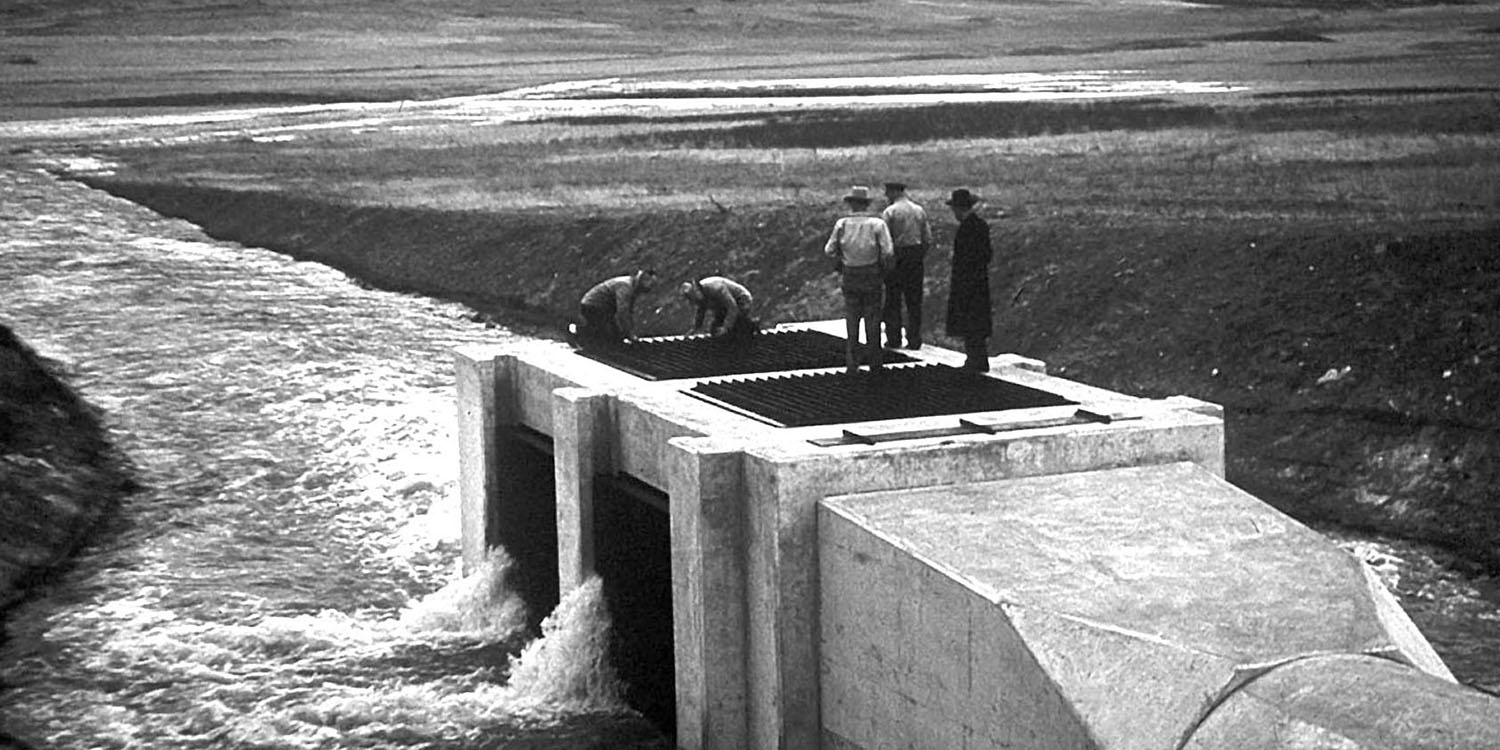

1952Sept. 19, 1952Crews finish building the dams at Carter Lake.
-
1953Jan. 1, 1953Severe drought grips eastern Colorado through 1956.
-
April 2, 1953
-
June 1, 1953Following the death of Charles Hansen, Greeley Tribune editor and first Northern Water Board president, the District looks for a new headquarters location close to C-BT Project features and Reclamation’s new office southwest of Loveland.
-

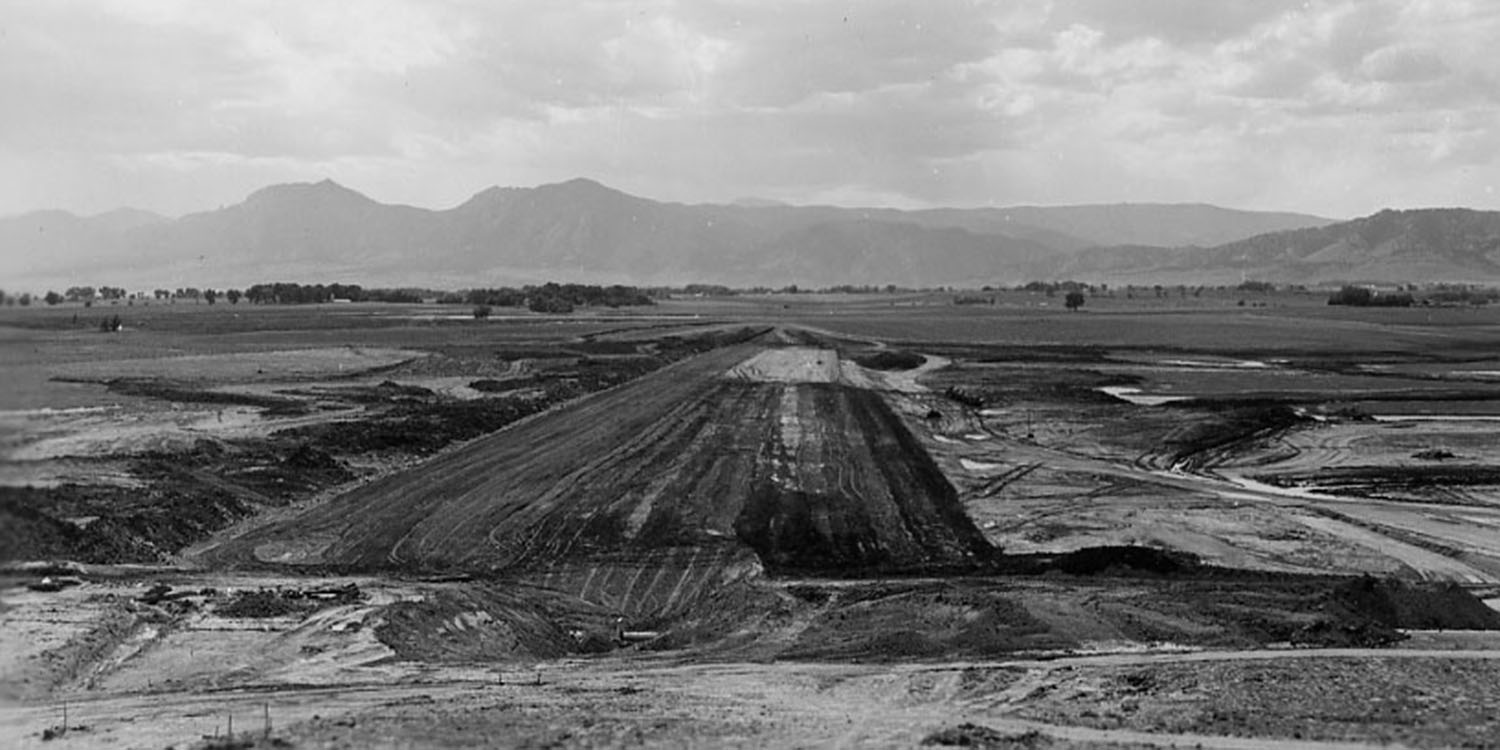

Sept. 8, 1953The Northern Water Board votes to include the City of Boulder in District boundaries. The Board also agrees to purchase 2.6 acres west of Loveland for a new headquarters. The site is a cherry orchard.
-
1954Feb. 26, 1954
-
May 27, 1954
-
1955Oct. 12, 1955U.S. District Court issues a final decree stipulating the quantities of water the C-BT Project may divert, store and deliver.
-
1956Jan. 1, 1956Construction crews finish the South Platte Supply Canal, the final C-BT Project feature Congress authorized in 1937.
-
Aug. 11, 1956
-
Sept. 10, 1956Northern Water and Reclamation officials sign C-BT Project Supplemental Contract No. 2, authorizing a five-year interim period for Northern Water to accumulate reserve funds for possible emergencies.
-
19571957The C-BT Project is declared complete and fully operational.
-
1960Nov. 9, 1960
-
1962Jan. 1, 1962A 40-year repayment period commences for Northern Water's portion of C-BT Project facilities and construction costs.
-
1965October 1965
-
19681968Northern Water purchases 11 acres adjoining the south and west sides of its current property to expand its headquarters.
-

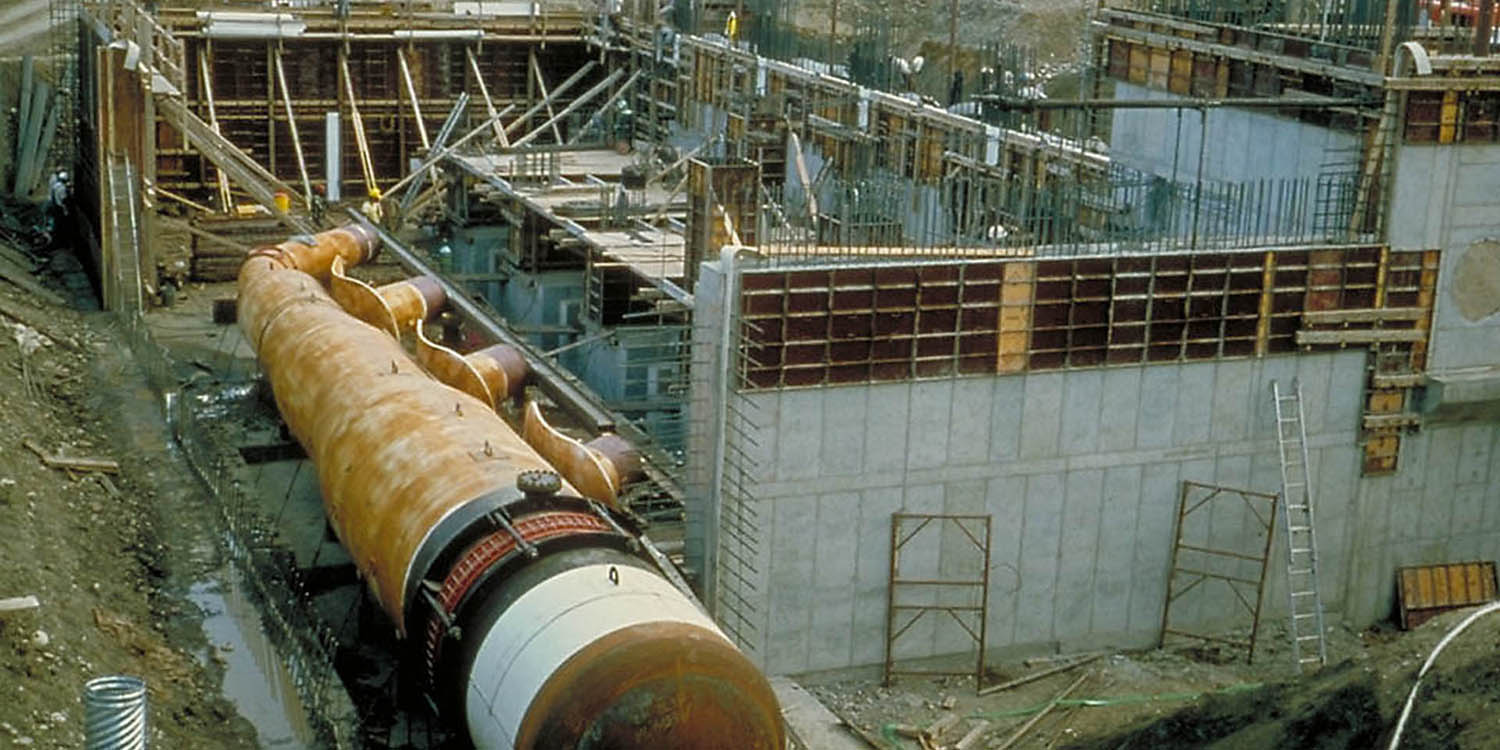

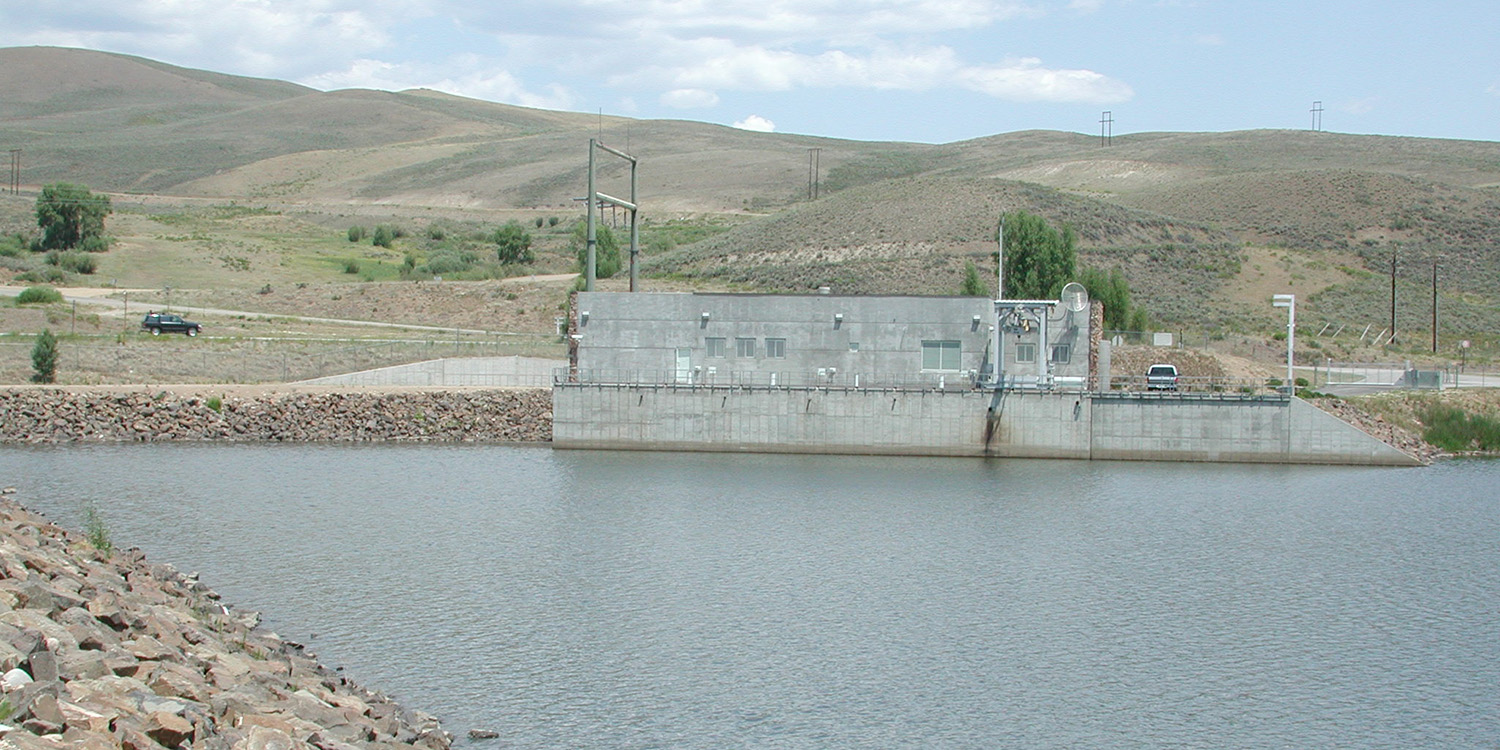

1970July 6, 1970Windy Gap Project participants formally establish Northern Water's Municipal Subdistrict, the first subdistrict ever created under the Water Conservancy Act. Construction begins on a new Northern Water headquarters.
-
1971April 27, 1971
-
1973Oct. 3, 1973Northern Water, Subdistrict and Reclamation sign a carriage contract, allowing the Subdistrict to utilize C-BT Project facilities to transport and deliver the Subdistrict’s Windy Gap Project water.
-

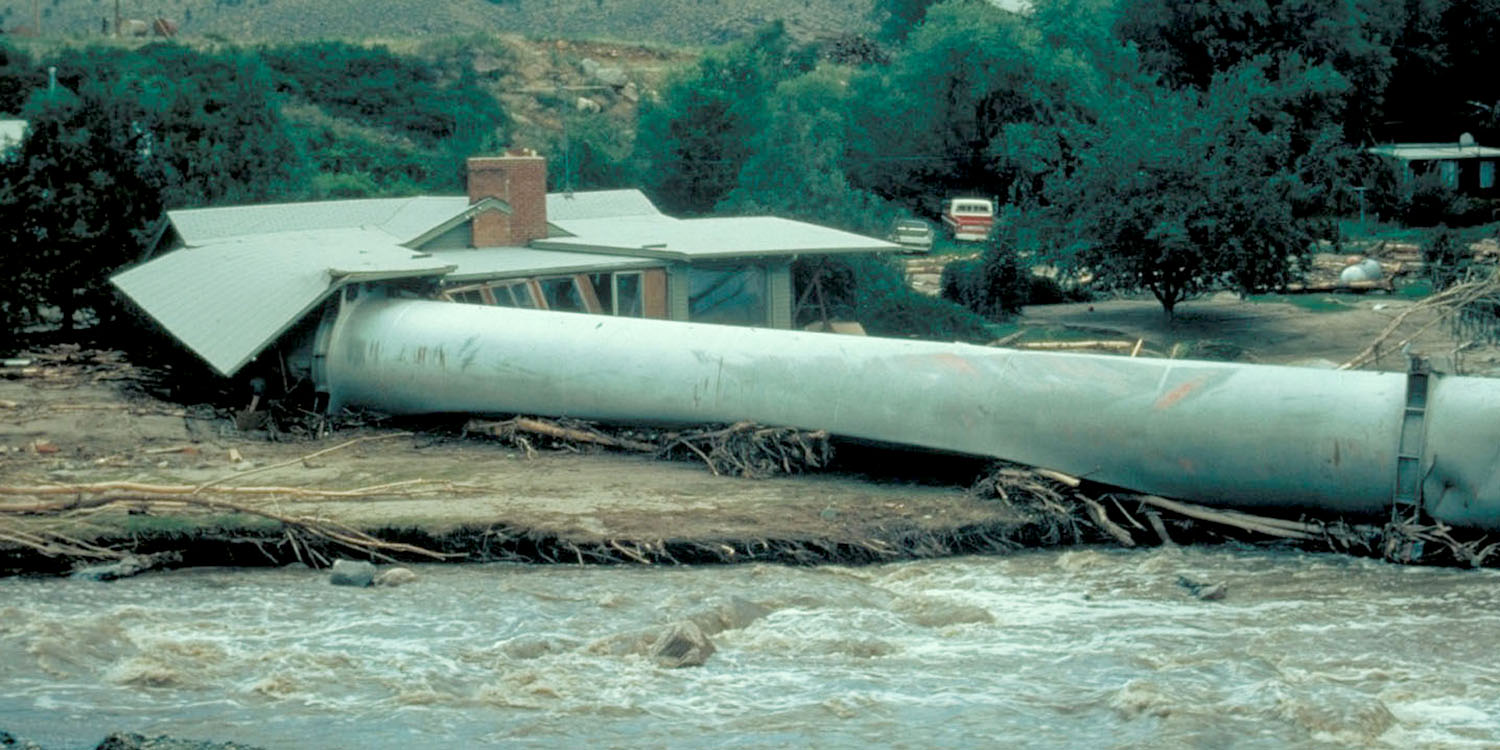

1976July 31, 1976
-
19771977Drought hits northeastern Colorado from 1977 to 1978, and Horsetooth Reservoir reaches its lowest level since it was first filled in the 1950s.
-
1980April 30, 1980The Subdistrict reaches an agreement with the Colorado River Water Conservation District and other West Slope interests. The West Slope agrees to no longer oppose the Windy Gap Project, and the Subdistrict commits to study and construct the Azure Project to benefit the West Slope.
-
19811981Northern Water establishes an Irrigation Management Service to promote wise agricultural water use. The IMS is part of Northern Water's commitment to water conservation.
-
July 11, 1981
-
1985March 29, 1985The Subdistrict agrees to pay $10.2 million to the West Slope when plans for the Azure Project are scrapped. This supplemental agreement removes the last hurdle to the Windy Gap Project.
-
June 29, 1985Subdistrict officials dedicate the Windy Gap Project.
-
19861986The City of Thornton pays $55 million for 21,000 acres of farmland in Weld and Larimer counties. The city intends to transfer the farms’ irrigation water to Thornton via a 56-mile pipeline.
-
April 9, 1986Thornton makes public its plan to divert water from Northern Colorado.
-
June 1, 1986Northern Water assumes operation and maintenance responsibilities for C-BT collection facilities on the West Slope.
-
October 1986President Reagan signs legislation designating a large segment of the Cache la Poudre as Colorado's first wild and scenic river.
-
1987Feb. 1, 1987Northern Water assumes operation and maintenance responsibilities for Horsetooth Reservoir and Carter Lake. By 1987 Northern Water has 56 full-time employees; approximately half are employed in the Operations and Maintenance Branch.
-
Sept. 20, 1987Northern Water marks its 50th anniversary with a celebration at its headquarters in Loveland.
-
October 1987The Bureau of Reclamation announces a reorganization plan, shifting the 85-year-old agency's focus from project construction to water resources management.
-
19881988
-
1989Feb. 6, 1989A Water Division No. 5 judge grants the Subdistrict absolute decrees to pump and store Windy Gap Project water.
-
1991March 1991The Central Colorado Water Conservancy District imports the concept of children's water festivals to Colorado from Nebraska and hosts Colorado's first children's water festival.
-
June 3, 1991Northern Water begins offering C-BT Project water for seasonal rental. People line up as early as 2 a.m. to rent water.
-
June 14, 1991Northern Water and Subdistrict boards vote to include the City and County of Broomfield within Northern Water and Subdistrict boundaries.
-
July 1991Northern Water staff release the Northern Colorado Regional Water Supply Study, including information about projected future water demands.
-
1991Northern Water begins preliminary design work on the Southern Water Supply Project pipeline to deliver C-BT and Windy Gap water from Carter Lake to cities and towns year-round.
-
1992May 19, 1992Children's water festivals spread across Northern Colorado. Northern Water sponsors its first festival in Fort Collins.
-
October 1992The University Press of Colorado publishes "The Last Water Hole in the West," a history of Northern Water and C-BT Project. The book's author is Colorado State University historian Daniel Tyler.
-
19931993Northern Water expands its Irrigation Management Service to include a Turf and Urban Landscape Water Management and Conservation Program component. By 1993 municipalities own more than half of C-BT Project units.
-
November 1993
-
19941994
-
June 18, 1994
-
1995Dec. 13, 1995
-
1996May 1, 1996
-
July 16, 1996Crews install the last segment of the Fort Lupton-Hudson pipeline, completing the second phase of the Southern Water Supply Project.
-

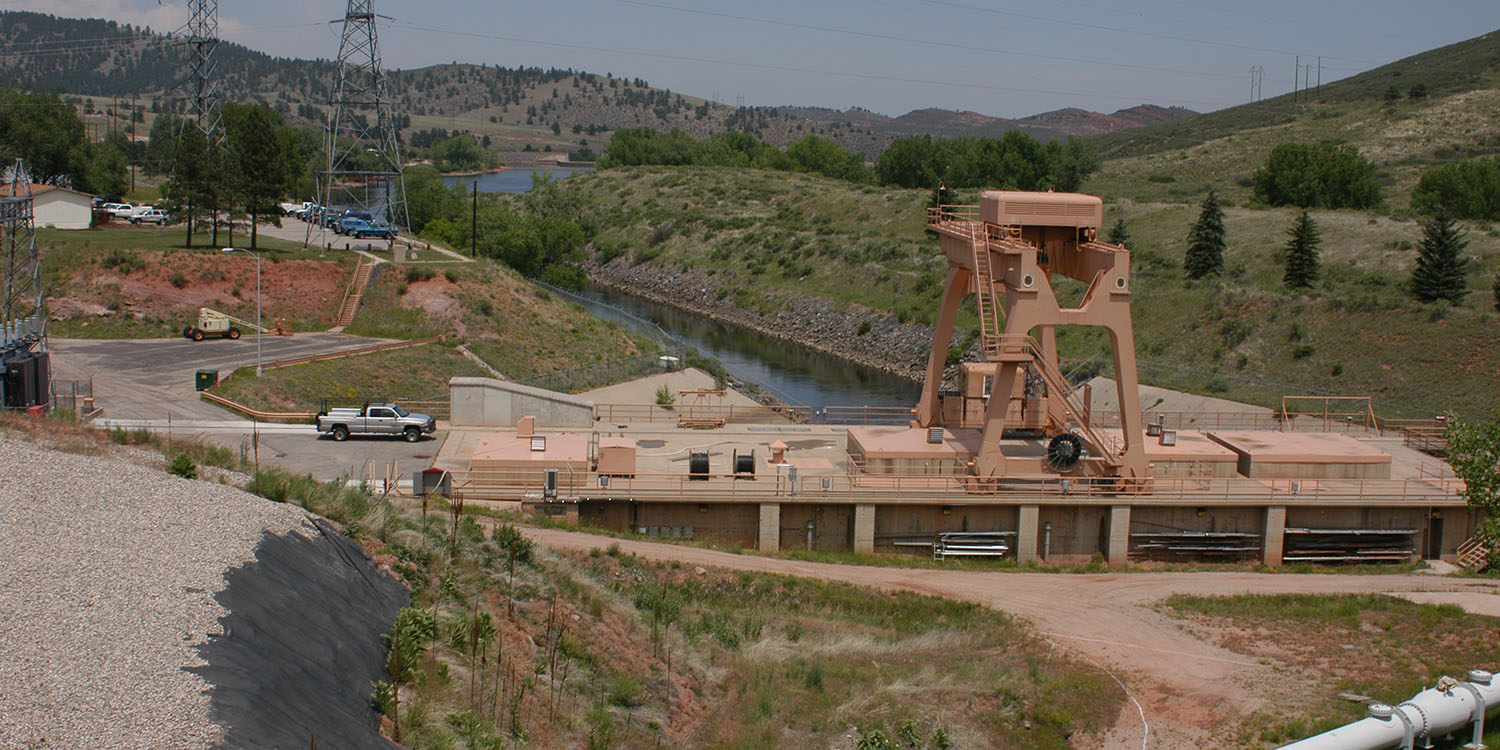

1996Following repairs, Reclamation personnel test and ready the Flatiron Pump Plant Unit No.3.
-
1997Feb. 7, 1997Northern Water and Municipal Subdistrict boards vote to include the City of Louisville within Northern Water and Municipal Subdistrict boundaries.
-
Sept. 1, 1997Engineers begin designing a third phase of the Southern Water Supply Project pipeline, a 42-mile segment from Platteville to Fort Morgan.
-
November 1997Northern Water purchases 35 acres on the north side of Berthoud to consolidate all East Slope employees, facilities and activities at a new headquarters site.
-
1998April 1, 1998
-

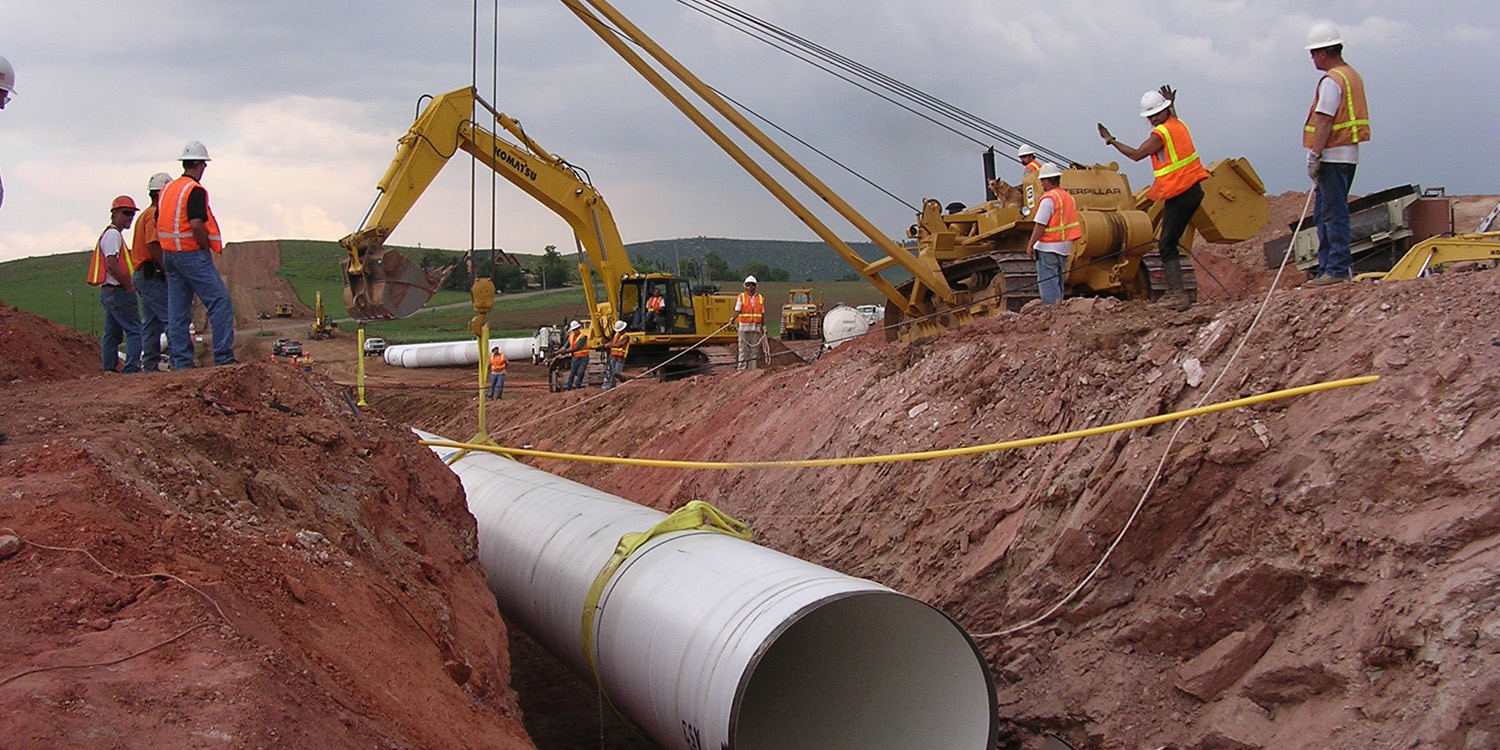

August 1998Pleasant Valley Pipeline participants settle on a project design. The reversible pipeline will benefit Larimer and Weld county residents.
-
October 1998Crews begin constructing a bypass flow structure at the Flatiron Power Plant. The bypass will enable water to bypass Flatiron in the event of a plant failure. The plant produces hydropower and also pumps water 300 vertical feet to Carter Lake.
-
December 1998Construction of the Flatiron bypass structure is complete.
-
19991999Windy Gap Project participants and the Subdistrict consider several potential reservoir sites on both the East and West slopes to store Windy Gap Project water from 1999 to 2000. This effort becomes known as the Windy Gap Firming Project, an effort to firm the relatively junior Windy Gap Project water rights and provide storage independent of the C-BT Project.
-
September 1999Crews finish work on the Southern Water Supply Project pipeline’s final 42 miles from Platteville to Fort Morgan.
-
20002000Sustained drought hits northeastern Colorado until 2006, resulting in agricultural water shortages and municipal water use restrictions.
-
January 2000Northern Water and Reclamation unveil plans to modernize Horsetooth Reservoir’s four 50-year-old dams to make the structures more earthquake resistant and reduce seepage.
-
April 2000
-
April 2000Northern Water and Colorado Division of Wildlife officials agree to construct additional game ramps in several C-BT Project canals. The ramps enable stranded wildlife to exit the canals safely.
-
June 13, 2000
-
July 14, 2000The Northern Water Board approves a contract with RB+B Architects, Inc. to design new headquarters facilities in Berthoud.
-
Oct. 27, 2000President Clinton signs legislation authorizing title transfer of four C-BT Project facilities from the U.S. government to Northern Water. All are located downstream of Horsetooth Reservoir and include the North Poudre (Munroe Gravity) and Charles Hansen supply canals, the Windsor Extension and the Dixon Feeder Canal.
-
December 2000Northern Water and Reclamation sign C-BT Project Supplemental Contract No. 7 to modernize Horsetooth Reservoir’s four 50-year-old dams.
-
2001February 2001The Bureau of Reclamation contracts with Delhur Industries to modernize Horsetooth Reservoir’s four dams.
-
2002April 2002The Northern Water Board approves a contract with FCI Constructors, Inc. for the new Berthoud headquarters facilities.
-
June 17, 2002The Bureau of Reclamation marks its 100th anniversary with a celebration at Hoover Dam on the Colorado River near Las Vegas, Nevada.
-
August 2002
-
October 2002The Northern Water Board moves its initial quota declaration to October, establishing winter-time water delivery accounts and allowing water users to transfer water before the traditional quota declaration each April.
-
December 2002Northern Water makes its final payment to the federal government, fulfilling its financial obligations under the original C-BT Project Repayment Contract and the C-BT Project Supplemental Contract No. 2. Northern Water continues to repay its portion of Horsetooth Modernization Project costs under C-BT Project Supplemental Contract No. 7.
-
2003January 2003Northern Water begins investigating water project alternatives within the South Platte, St. Vrain, Big Thompson and Cache la Poudre watersheds for a potential Northern Integrated Supply Project.
-
April 2003The Subdistrict pumps a record-setting 64,200 acre-feet of Windy Gap Project water to Lake Granby.
-
Sept. 2, 2003
-
October 2003After more than two-and-a-half years of work the Horsetooth Modernization project is complete. The same month work begins on the 8.5-mile Pleasant Valley Pipeline.
-
2004Feb. 13, 2004Northern Water and Subdistrict boards vote to include the City of Lafayette within Northern Water and Subdistrict boundaries.
-
March 2004
-
April 2004Northern Water expands its water quality monitoring program, a multi-agency effort to monitor and maintain the C-BT Project’s supply of high-quality water.
-
August 2004The Northern Water Board adopts new Carryover Program rules and a Carryover Capacity Transferability Program to more flexibly manage C-BT Project water supplies.
-
September 2004Northern Water implements online accounting, providing secure online access to C-BT Project allottees’ water accounts via the Northern Water website.
-
2005March 2005
-
May 2005Northern Water begins preliminary design work on a second Southern Water Supply Project pipeline from Carter Lake to cities within Northern Water and Subdistrict boundaries.
-
October 2005The Northern Water Board adopts a Regional Pool Program to increase water management flexibility and help preserve a portion of C-BT Project water supplies for irrigated agriculture.
-
November 2005The Northern Water Board signs agreements with the Bureau of Reclamation and URS Corporation to design a second outlet structure at Carter Lake.
-
2006March 2006Northern Water relocates a section of the St. Vrain Supply Canal upstream of the Little Thompson Siphon due to unstable geology. The canal is back in operation and carrying water by early April.
-
April 2006The U.S. Senate passes H.R. 3443 conveying ownership of the St. Vrain Supply Canal, the Boulder Creek Supply Canal, and the South Platte Supply Canal from the U.S. Bureau of Reclamation to Northern Water.
-
July 31, 2006
-

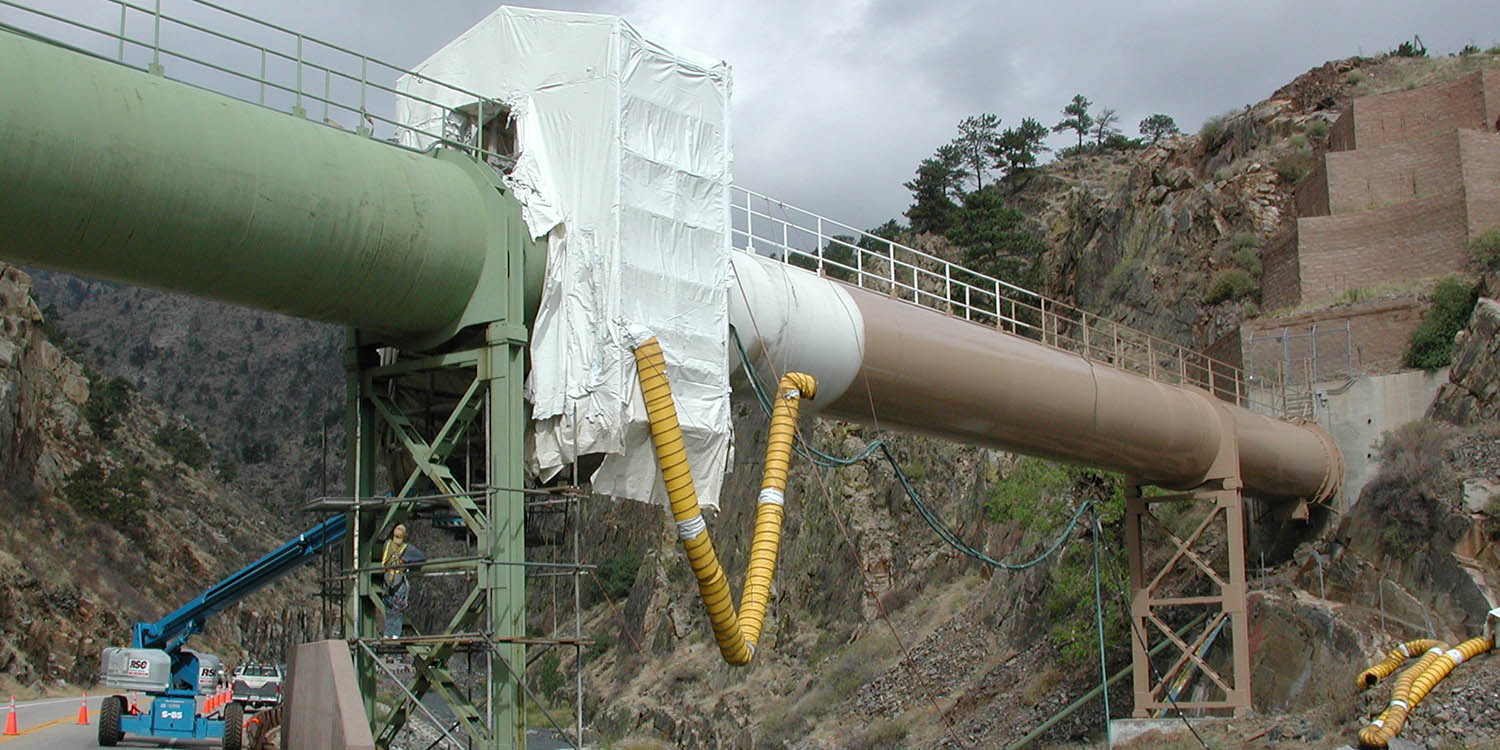

Oct. 15, 2006Northern Water staff begin lowering the water level in Shadow Mountain Reservoir 12 vertical feet to kill aquatic weeds by exposing them to freezing temperatures for approximately five weeks. The reservoir’s location and lack of depth make it fertile ground for aquatic weed growth.
-
2007April 2007The Northern Water Board endorses staff’s recommendation to use “Northern Water” as an abbreviated reference for “Northern Colorado Water Conservancy District” to facilitate name recognition. Previously the organization was known by multiple references, including The District, Northern, The Northern District, The Water District, NCWCD and others.
-
October 2007
-
2008January 2008The Northern Water Board adopts a new logo to replace the organization’s existing 20-year-old logo.
-
July 2008Reclamation confirms the presence of quagga mussels in Lake Granby. Quagga mussels are an invasive species similar to zebra mussels. Both types of mussels drive out native species, block industrial pipes and can clog boat motors.
-
2009April 2009
-
2010March 2010The Northern Water Board allocates 10,000 acre-feet of C-BT Project water from the Regional Pool; water users bid on and lease the entire amount. Adopted by the Board in 2005, the Regional Pool Program provides greater flexibility and to preserve some C-BT water supplies for irrigated agriculture.
-
July 2010The Northern Water Board allocates an additional 15,000 acre-feet of C-BT Project water from the Regional Pool; water users bid on and lease only 1,030 acre-feet due to plentiful supplies.
-
October 2010Northern Water rehabilitates the connecting channel structure between Grand Lake and Shadow Mountain Reservoir. Built in the mid-1940s, the structure helps control surface levels in both water bodies.
-
2011February 2011The Northern Water Board approves construction of a hydroelectric power plant at Carter Lake. When complete the project will generate enough electricity to power a town of approximately 5,000 people.
-

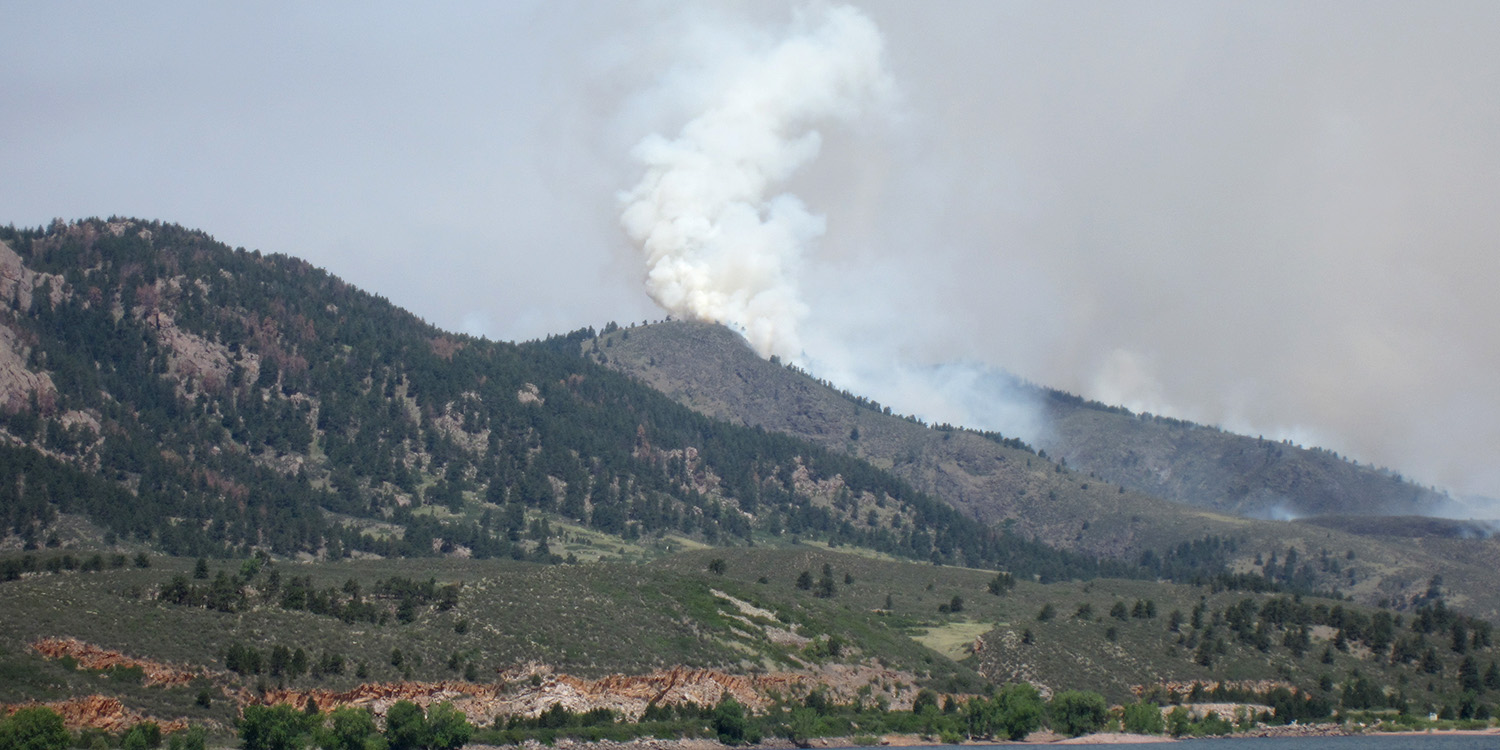

2012May 31, 2012
-
June 9, 2012
-
Sept. 20, 2012Northern Water marks its 75th anniversary with a celebration at its headquarters in Berthoud.
-

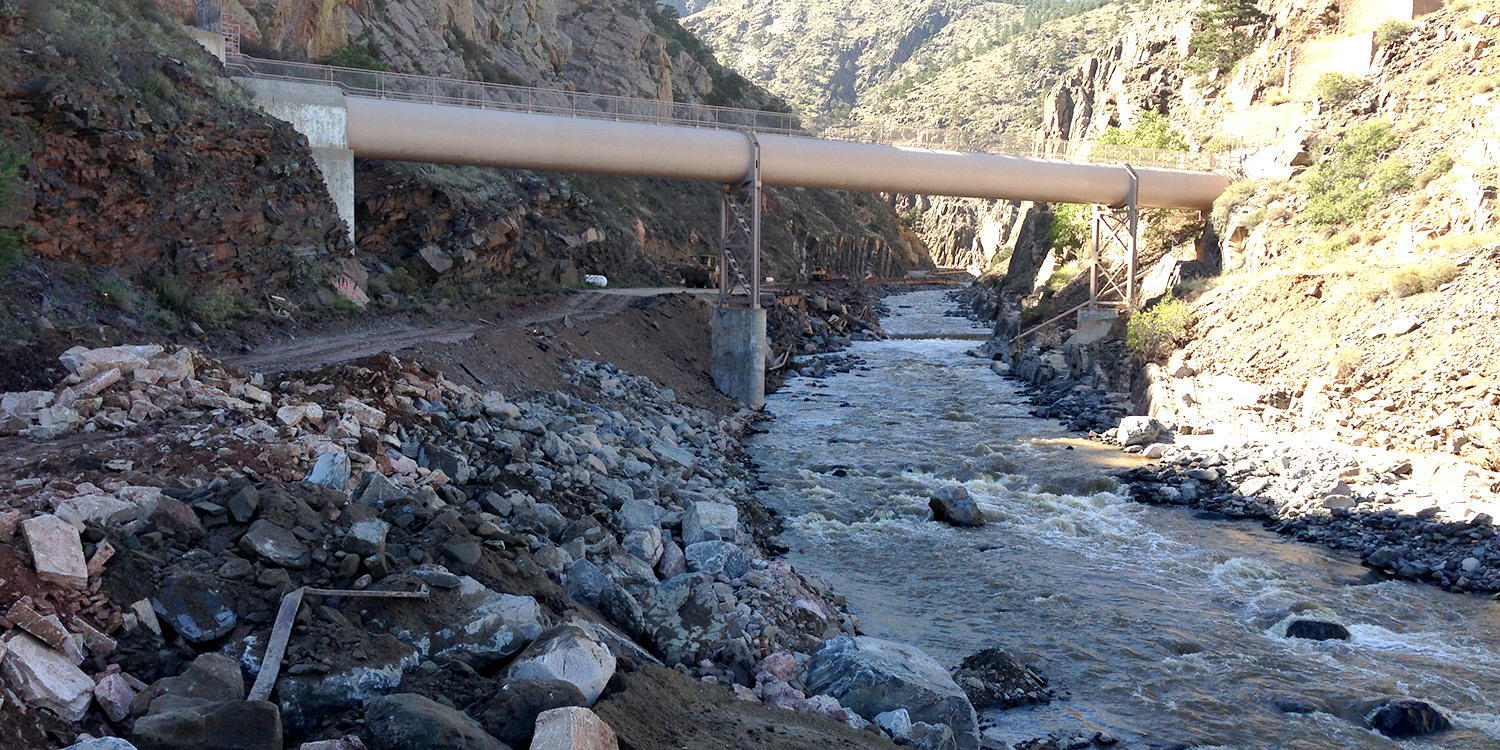

2013July 2013Northern Water signs a water lease agreement with the city of Grand Junction to provide more than 5,400 acre-feet of water for municipal and recreational use in Grand Junction through releases out of Lake Granby down the Colorado River. This agreement helps fulfill a commitment under the Upper Colorado River Endangered Fish Recovery Program for additional water in a 15 Mile Reach of the Colorado River above Grand Junction.
-
September 2013
-
November 2013Northern Water completes a multi-year effort to rehabilitate the original Carter Lake outlet structure. Constructed in the mid-1950s, the original outlet was intended for large-volume water deliveries only during the irrigation season. Year-round water deliveries to cities and towns severely limited Northern Water’s ability to repair the aging structure until a new outlet at Carter Lake was finished in March 2008.
-
2014March 11, 2014Northern Water Directors initially approve the construction of a hydropower plant at the outlet of Granby Dam on Lake Granby in Grand County (Granby Hydropower Project).
-
October 2014Water storage levels in the C-BT Project reach an all-time high; more than 200,000 acre-feet above average and 20 percent greater than the previous record set in 1997.
-
Dec. 19, 2014Following years of effort, the U.S. Bureau of Reclamation, Northern Water and its Municipal Subdistrict sign a new Windy Gap carriage contract. Simultaneously, Reclamation issues a Record of Decision enabling the Windy Gap Firming Project to proceed towards design and construction of Chimney Hollow Reservoir west of Carter Lake. At the same Board meeting, Northern Water Directors approve several financial agreements to proceed with the Granby Hydropower Project at Lake Granby.
-
2015March 13, 2015The Northern Water Board approves a contract with Aslan Construction for the Granby Hydropower Project at Lake Granby. When operating at capacity the hydropower facility at Granby Dam will provide approximately 50 percent of the current capacity of the Trout Hydropower Plant at Carter Lake.
-
May 2015During late April and May, much of Northeastern Colorado receives approximately 200-300 percent of normal precipitation, leading to localized flooding.
-
2016June 3, 2016
-
2017May 16, 2017The U.S. Army Corps of Engineers issues a Record of Decision enabling the Subdistrict to proceed with construction of Chimney Hollow Reservoir, the key component of the Windy Gap Firming Project.
-
2018May 2018Construction begins on a second Southern Water Supply Project pipeline (SWSP II) from Carter Lake. The $44 million pipeline parallels the first SWSP pipeline from Carter Lake to the west side of Longmont. From there the new pipeline will head southwest to serve both the Left Hand Water District and the City of Boulder’s water filtration plant at Boulder Reservoir.
-
2020January 2020The Water Quality Control Division of the Colorado Department of Public Health and Environment issues the Northern Integrated Supply Project the Colorado 401 Water Quality Certification.
-
July 15, 2020The Larimer County Planning Commission recommends approval of a county 1041 permit for the Northern Integrated Supply Project to the Board of County Commissioners, which ultimately will decide whether to issue a permit.
-
September 2020
-
Sept. 2, 2020The Northern Integrated Supply Project achieved an important milestone with the Larimer County Board of County Commissioners approving the 1041 Land Use Permit application.
-
October 2020
-

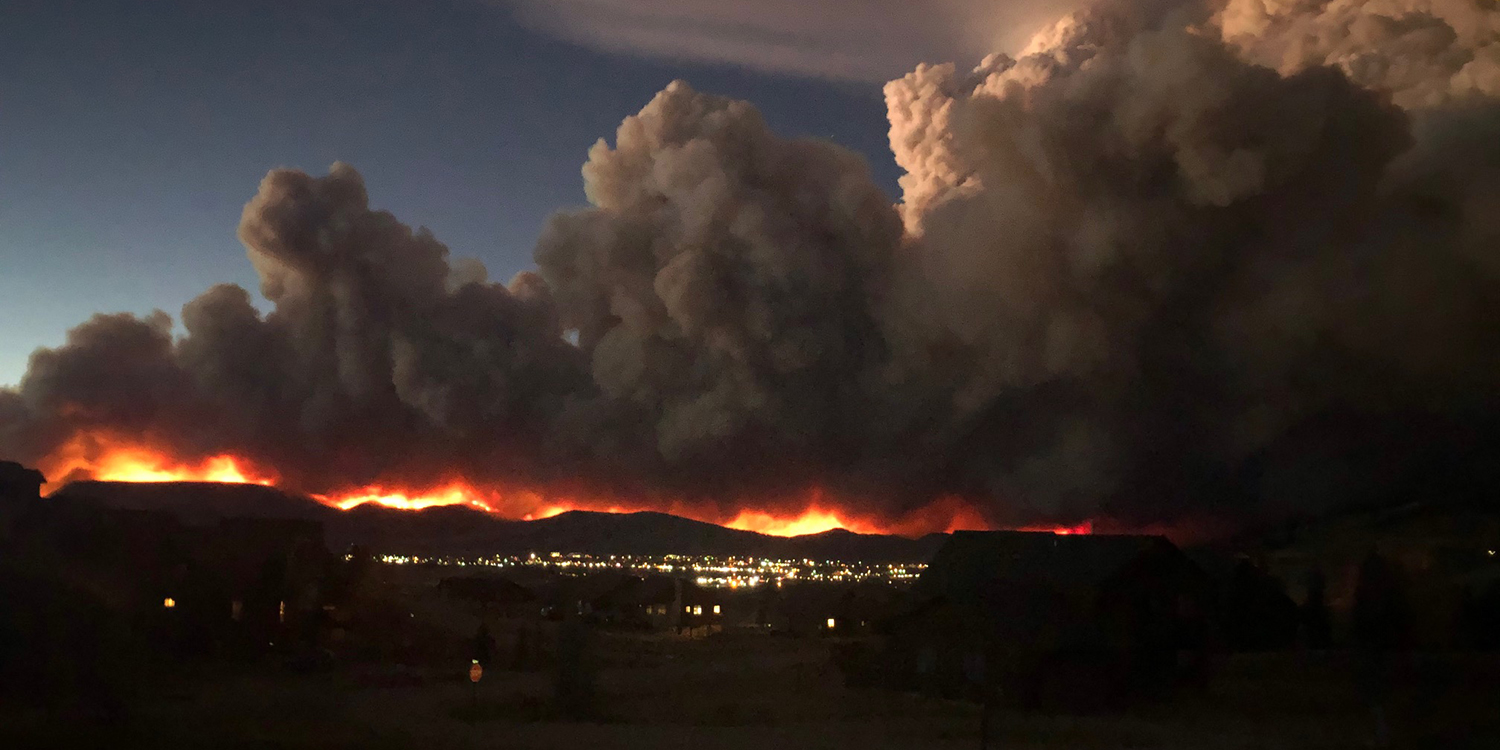

Dec. 10, 2020Federal Court rules in favor of the Windy Gap Firming Project, clearing the way for construction of Chimney Hollow Reservoir near Berthoud.
-
2021Feb. 12, 2021The Northern Water Board of Directors and Grand County Board of County Commissioners agree to be sponsors for the Emergency Watershed Protection Program for the East Troublesome Fire recovery effort and for the Grand County Watershed Recovery group. The EWP Program is managed by the U.S. Department of Agriculture’s Natural Resources Conservation Service. Its purpose is to implement watershed protection projects that mitigate risks to life and property caused by sudden watershed impairments such as post-fire flooding, sediment loading and debris flows.
-
May 13, 2021
-
June 17, 2021
-
Aug. 6, 2021
-
Aug. 16, 2021
-
2022April 2022The Northern Water Board of Directors is expanded to 13 members. The additional member represents the City and County of Broomfield.
-
June 1, 2022
-
Aug. 23, 2022Dignitaries from across the region gather to celebrate the start of construction at the Colorado River Connectivity Channel located in Grand County. Led by U.S. Sen. Michael Bennet, leaders of public agencies and private non-governmental organizations extol the value of the project that will reconnect two segments of the Colorado River above and below Windy Gap Reservoir.
-
September 2022
-
Dec. 9, 2022The U.S. Army Corps of Engineers issues a federal Clean Water Act Section 404 Record of Decision for the Northern Integrated Supply Project. This is a major milestone for NISP, as it reflects the lead federal regulatory agency’s review and approval of the project. The Corps’ approval is based on a lengthy and rigorous scientific analysis under the National Environmental Policy Act and a host of other environmental laws, including the federal Endangered Species Act, National Historic Preservation Act, State Water Quality compliance certification, and State Fish and Wildlife Mitigation Plan requirements.
-
2023May 25, 2023
-
July 10, 2023The highest daily total for the C-BT Project occurs when 803,291 acre-feet of water is in storage, surpassing the previous record set on July 14, 2019, by 769 acre-feet.
-
2024June 2024
